DumpsBase offers AACE-PSP dumps (V10.02) in a convenient PDF format and an online practice test simulator to help you complete your AACE Planning & Scheduling Professional (PSP) Exam. These two formats help you practice all the exam questions and answers thoroughly, building your confidence and familiarizing yourself with the exam structure. Before downloading our AACE-PSP dumps (V10.02) from DumpsBase, you can explore our AACE-PSP free dumps (Part 1, Q1-Q40) online. This preview showcases the quality and features of the AACE-PSP exam dumps. Choose DumpsBase today, we guarantee success in the AACE Planning & Scheduling Professional (PSP) exam with our AACE-PSP dumps (V10.02). Today, we will continue to share our demo questions.

Below are our AACE-PSP free dumps (Part 2, Q41-Q80) of V10.02 for checking more about our materials:

1. SIMULATION

Background

Your name is Evan Marshal. You are the corporate scheduler for Happy Insurance Corporation (HIC), a general health insurance company located in Ridgemond, Illinois. HIC is very busy with 49 unique software development projects. The organization structure at HIC gives the project scheduling responsibility to the Project Manager assigned to each project. You are charged with coordination of

the project schedules into a Master Schedule and quality control for scheduling on the individual development projects. You report directly to the Director of Information Services (DIS), Desmond Rayburn.

It has come to your attention Project JP-114 has fallen behind schedule and Rita Belateau, the Project Manager, wants to accelerate the project in order to reclaim lost time. Rita is a strong supporter of Total Quality Management and strives for zero failures; therefore she is assessing the need for overtime for resources assigned to an activity that is not projecting a completion prior to the early finish depicted in the current schedule.

You and Rita review the current schedule to identify which activities are on the critical path and which activities have plenty of float. The review reveals several activities have suffered less than planned productivity and have contributed to falling behind. In the process of this review, you and Rita also review the budget for Project JP-114 and notice not only the schedule has fallen behind but the cost to date is more than she had expected. To total budget is $150,000, planned to date is $30,000; expended to date is $37,000.

With nine months remaining until baseline contract completion, Rita needs to bring Project JP-114 back on track; knowing overtime for an extended period of time is not always the right answer, especially with the cost to date already over planned.

In order to truly understand the options available to help remedy the current situation, you and Rita brainstorm on several potential courses of action. All the potential courses of action will require an evaluation of budget impact versus schedule correction.

1. Pull the project team together and ensure everyone understands which activities are on the critical path. Rita would like to use the existing project team and focus them on these critical path activities, laying out a plan for periodic overtime when needed to crunch through a deliverable. This approach could add approximately 20% to the budget.

2. Outsource various modules of activities to qualified and known consultants. This could drive up the costs and must be evaluated before implemented. Having an outside source working in parallel with the project team could also accelerate the schedule to mitigate some of the delays, as well as keep overtime down to a minimum for the project team. Potentially this could add as much as 40% to the budget, but could also be very productive schedule wise.

3. Mandatory overtime for the project team - entire project goes on a 50-hour work week. If the

entire project team works overtime for an extended period of time, the budget could see an additional 60% increase.

4. The project continues as is completes the project late and accepts the penalties imposed. Penalties imposed for late delivery could add as much as 50% to the budget.

Assignment

Draft a proper memorandum to Desmond Raybum, IS Director, explaining in your own words:

a the current problem and potential impact(s);

b each course of action, stating advantages and disadvantages as appropriate;

c your recommendations, properly supported.

Please be sure to include the rationale for your recommendations. Be sure to summarize your thoughts and address (To, From, Date, and Subject/Project Name) and close the memo appropriately. If you are uncomfortable with the courses of action noted, provide your own with appropriate substantiation for your position. Limit your answer to one, full typewritten page (roughly three handwritten pages).

While your email can be a detailed as you like, be sure to write sufficiently to address each element of the assignment, yet not so long that you go beyond the scope of the exercise.

Take time to read the problem and consider what you want Evan to say. Good luck!

2. In its simplest form, what is the main drawback of critical path method scheduling?

3. Each of the following accurately describes total float in a schedule EXCEPT:

4. Using the "normal" schedule, if you start Activity 7001 on April 1, 2002, and using a 5-day workweek, what the finish date for Activity 7001?

5. Which statement is true?

6. Which of the following documents is most likely to be of the LEAST value to a planner/scheduler when planning a contractor's baseline critical path schedule for the construction of a large high-clearance bridge located very near an airport? The contractor has been awarded the contract.

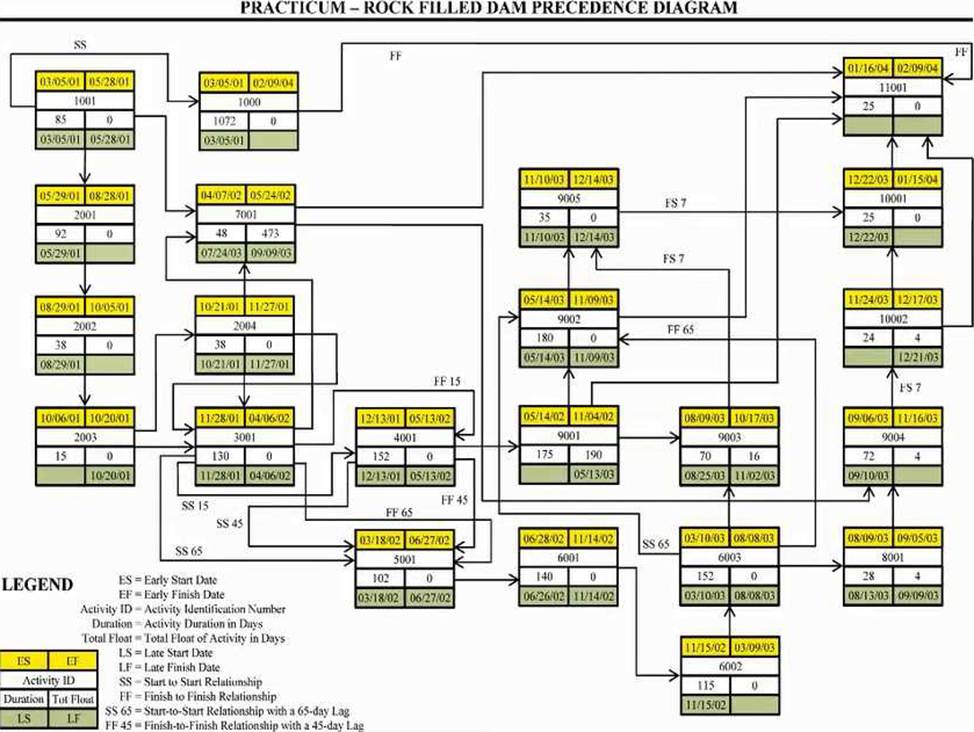

7. When reconstructing a CPM schedule electronically from a hardcopy, which of the following is NOT required to determine the critical path?

8. Determine the correct formula and date for the late finish for Activity 9004.

9. What activities are concurrent to Activity 2001 in the "normal" schedule?

10. An earned value-based project control system can use either of which two budgets as the basis of its

calculations?

11. If someone wanted to constrain a project's end date so that any project slippage would cause negative float, they would do so by using

12. By subtracting a measured unit productivity rate during an impacted period from the unit productivity rate during an unimpacted period, the resulting value represents:

13. What method offers the best chance of the schedule being used effectively to implement the project in the field?

14. Determine the correct formula and date for the late finish for Activity 2001.

15. Which of the following are NOT considerations or constraints of the planning process for construction scheduling?

16. If a detailed estimate is NOT available to assist in the formulation of activity durations but unit quantities have been identified, what information can be utilized to estimate work package/activity durations?

17. Which of the following is NOT a tool or technique used to perform scope planning?

18. In the "normal" schedule, excluding Activity 1000, what activity(s) are concurrent with Activity 3001?

19. Time-scaled logic diagrams are

20. Determine the correct formula and date for the late start for the Activity 11001:

21. Assuming conventional finish-to-start relationships, to calculate a schedule retaining the existing logic means that

22. Which of the following types of delay will NOT result in a time extension and additional compensation for a contractor?

23. Using the "normal" schedule, theoretically construct a hammock for activities 2001 through 2004.

What is the duration of the hammock?

24. The amount of time that an activity can be delayed from its early start date without delaying project completion is called:

25. Determine the driving activity for Activity 10001.

26. You are developing a detailed critical path schedule for a proposed petrochemical plant. The schedule will become a part of the project baseline document, which will be sent to the company's board of directors for its consideration.

What document or resource is likely to be MOST valuable in determining the schedule's work activity durations?

27. If the administrative constraints for developing the precedence diagram, as provided in the contract documents, indicate that no individual construction activities shall have a longer duration of two months, how many activities in the "normal" schedule would be affected?

28. Which of the following is NOT input data to the construction planning process?

29. Using the "crashed" schedule, if you start Activity 2002 on August 12, 2001, what is the finish date for Activity 2002?

30. Resource planning must take all of the following into account except for:

31. In order for a claimant to be entitled to an extension of contract time for a delay event (and further to be considered compensable):

32. A driving relationship is _____________________.

33. Scenario:

The entire network consists of the following activities and relationships. Activity A is twenty days long and is tied to Activity B, a ten-day activity, with a finish-to-finish tie with a lag value of five Activity B is tied to Activity C, a twenty-day activity, with a start-to-start relationship with a lag value of five.

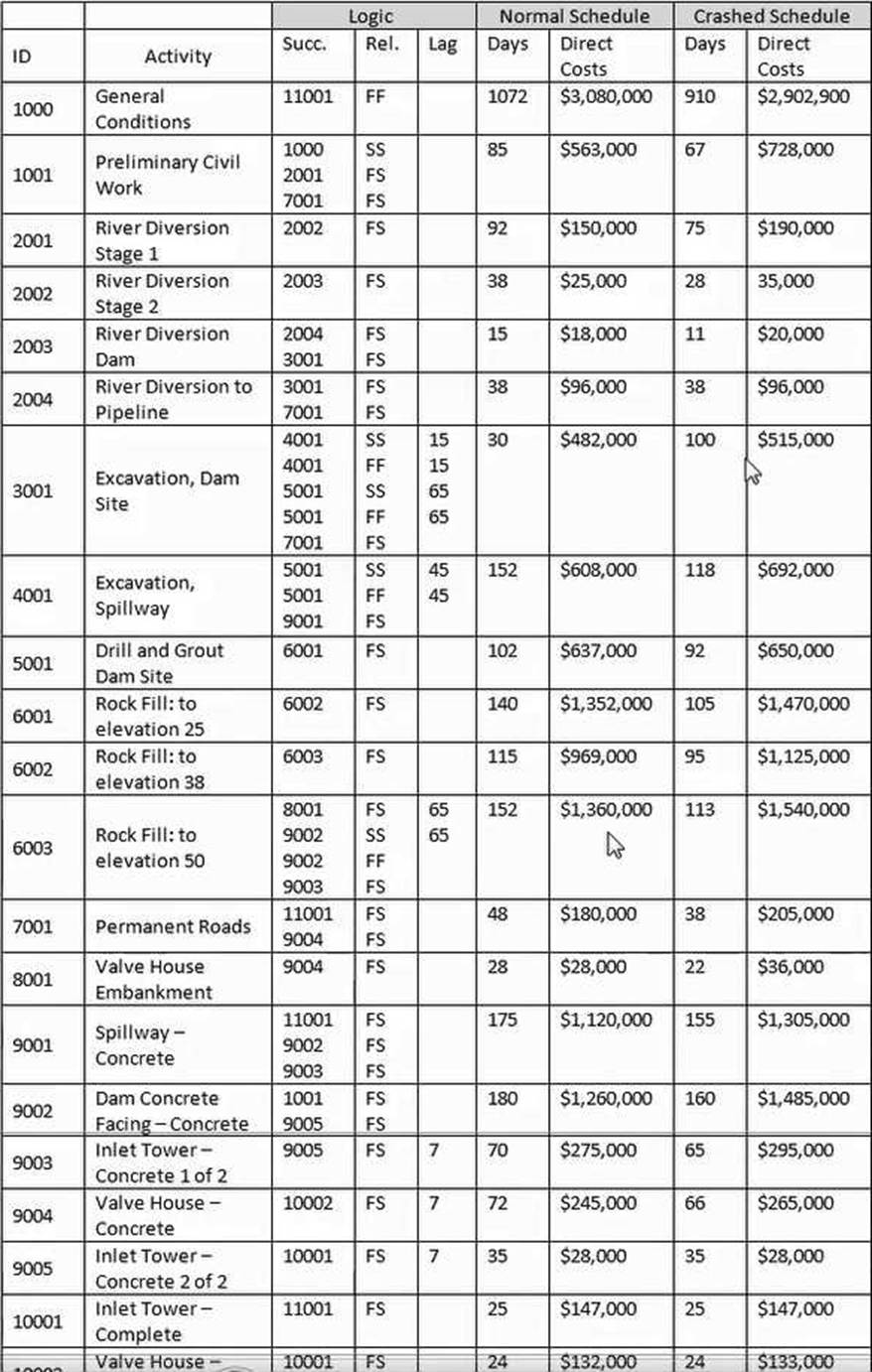

PSP Activities Table

Scope Known about Rock-Filled Dam Project:

The dam requires river diversion and work over two or more rainy seasons. The contract is lump sum, competitively bid, and will be self-performed. The owner has attempted to shift all risk to the contractor by employing "no differing sit conditions" and "no damage for delay" clauses. There is a bonus/penalty provision of $2,500 per calendar day for early or late delivery. The early completion bonus is capped at $500,000, with no cap for late delivery penalty.

Liquidated damages end at the finish of demobilization. Indirect costs per calendar day are $2,800 for the "normal" schedule and $3,200 for the "crashed" schedule. The winter/wet weather season is 151 days between October 15 and March 25 of each year, reduces the efficiency of the contractor's operations by 20% and costs the contractor $10,000 per day. Assume a start date of March 5, 2001 and use a 7-day work week.

The following table lists work activities as planned by the contractor.

Theoretically construct a summary activity for only those activities with a finish-to-start relationship for Activities 8001 through 10001.

Using the "normal" schedule, what is the cost of this hammock?

34. What is a key first step in developing a critical path method schedule?

35. Which of the following will NOT affect the total float calculation of a non-resource leveled schedule?

36. Project schedules help control all of the following EXCEPT for_____________________.

37. Project delays are best analyzed

38. Activity 1001 started on the scheduled date but has slipped 10 days. Activity 10002 will slip 35 days. All remaining activities retain their original duration.

What is the revised completion date?

39. Determine the correct formula and date for the late start for Activity 9001.

40. Free float is the
